Project management

After receiving drawings and BOQ's from client what would be the the next procedure toward project execution of Piping project.?

R
Raymund de Laza 👤 Member for 16 years 6 months

Hello Muhammad,

If you would mind, send the BOQ and Drawings and I prepare your detailed Schedule ready for Submission.



Regards,

M
Muhammad Ahmad 👤 Member for 7 years 10 months

Thanks
if you can plz attach the erection pre commissioning and activities also.

M
Muhammad Ahmad 👤 Member for 7 years 10 months

Thanks brother.

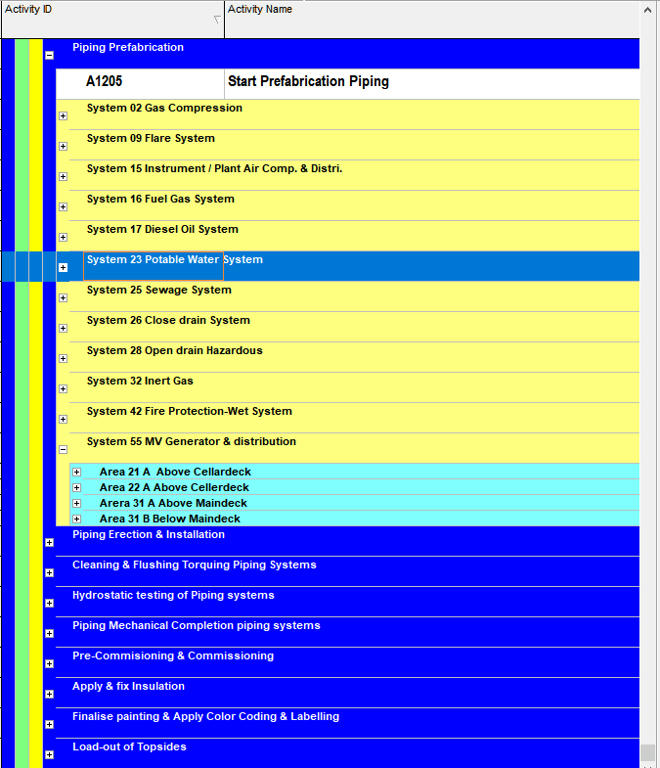

If the piping material is provided by the client and contractror have to fabricate it and then erection what kind of wbs will be in this conditions means sample or federal wbs for piping?

Z
Zoltan Palffy 👤 Member for 16 years 10 months

wbs would be how you want to break your piping down into smaller pieces like

You could have

General and in that wbst mobilization

Submittals?Approvals list your submittals and approvals here

Procurement list the items that you are procuring

Then you can break you work down as per this devel of detail

Building

........Level

............Area

...............Zone

..................And any other level to here the actual piping is being installed maybe by system or large bore vs small bore



no xer

M
Muhammad Ahmad 👤 Member for 7 years 10 months

Thank you brother. I am new in this field.
Can you plz tell me exact wbs for simple piping means mobilization, shop fab, field fab and also the activity details, this is my email [email protected] if you can send me the. .Xer file, it would be great.

V
Vladimir Liberzon 👤 Member for 25 years 4 months

Zoltan,

I suggest some changes to the order that you proposed:

1. create a wbs

2. create activities and milestones and assign activities to a wbs

3. assign relationships to activities

4. assign resources to activities

5. calculate and assign durations to activities

6. assign costs to resources and activities

7. set schedule constraints

8. calculate the schedule and the budget

9. create a baseline schedule narrative

10. issue for review

11. incorporate comments from review

12. Issue final version

Z
Zoltan Palffy 👤 Member for 16 years 10 months

1. create a wbs

2. create activities and assign activities to a wbs

3. assign relationships to activities

4. assign durations to activities

5. calculate the schedule

6. assign resources manhours and costs

7. Create a baseline schedule narrative

8. issue for review

9. incorporate comments from review

10.. Issue final version

M
Muhammad Ahmad 👤 Member for 7 years 10 months

Sorry
I wanted to know about planning and scheduling of piping project.
Means wbs, activities !

Forum Sponsor

Top Posters

Julian Pegg
1 posts
Peter Nagy
2 posts
Raymund de Laza
17 posts
Syed_Asad
0 posts
Tony Greyvenstein
0 posts
Ahmed Al-Jubouri
13 posts
Umar Alvi
3 posts
Sibusiso Mahlalela
0 posts
Michael Samanyayi
3 posts
Simon Gumede
0 posts
