Gantt Chart Activity

A
Ammar Abbas 👤 Member for 15 years 4 months

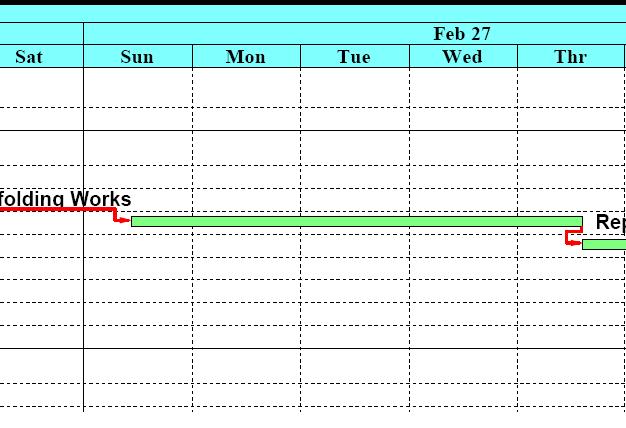

I am a beginner at primavera, i need to know how one can change gantt chart to show one day activity occupying the whole duration, like in this example activity starts somewhere mind sunday and ends in mid Thursday, where as I want it to start from the end of Saturday (start of Sunday) and continue till the end of Thursday, so that it occupies 5 days instead of 4.25 days approximately.

hope i m making it clear for you.

awaiting a response


R
Raymund de Laza 👤 Member for 16 years 7 months

Hi Ammar,

On your Project Calendar, make sure your day's working hour is set to 24 hours.

Hope this will help.



Regards,



Raymund
